Project Baseline

You can baseline a project and its tasks, and, in the future, compare actuals versus the baseline values to understand the deviation. Celoxis also supports Earned Value Analysis (EVA). In most scenarios, you would want to think of baseline as the "original estimate". In such cases, you would baseline the project just before kick-off. Celoxis currently supports only one baseline.

Creating a Baseline

Go to the project's gantt chart by clicking on . Then click on ToolbarBaselineSetProject. At any point in time, you can also choose to add or reset baselines of selected tasks. For example, if the scope increased and new tasks were added, you can add only these new tasks to the baseline by selecting this tasks and clicking on ToolbarBaselineSetSelected tasks.

The following fields are baselined:

  • Planned Start
  • Planned Finish
  • Planned Effort
  • Planned Cost
  • Budget

Visualizing the Baseline

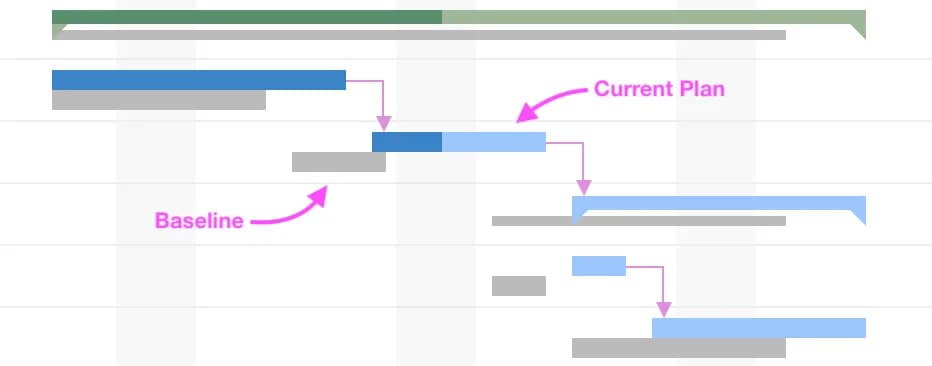

Go to the project's gantt chart by clicking on . Then click on ToolbarBaselineView.

Reporting on Baselines

Once you baseline project, the entire Earned Value Analysis (EVA) attributes like BCWS, BCWP, EV, PV, CPI and SPI are available in project and task reports. If you would to know more about earned value analysis, please read our blog article.

There are many baseline related columns available in projects and tasks.
